MC-7200 StormTech Isolator Row Plus Profile
Filename:
MC-7200 StormTech Isolator Row Plus Profile.dwg
MC-7200 StormTech Isolator Row Plus Profile
This document details StormTech MC-7200 StormTech Isolator Row Plus detail diagram, inspection port detail diagram and inspection/maintenance steps.

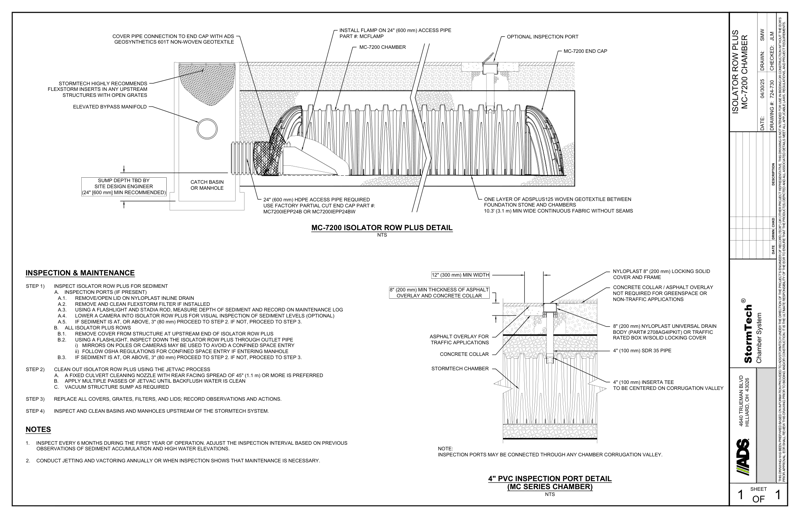

StormTech Isolator Row Plus detail diagram shows a cross section of the cover pipe connection to end cap, flamp access pipe install with the MC-7200 chamber, inspection port, Flexstorm inserts, sump depth, catch basin HDPE access pipe and geotextile layer between foundation stone and chambers.
The steps under inspection and maintenance require inspection of Isolator Row Plus for sediment, how to clean the Isolator Row Plus using the jetvac process, replacing covers, grates, filters and lids while recording observations and actions and inspection/cleaning basins and manholes upstream from the StormTech system.
A note suggests inspection occur every 6 months during the first year of operation and to adjust schedule based on observations of sediment. A maintenance note asks to conduct jetting and vactoring annually or when maintenance is necessary.
A 4” PVC inspection port detail shows the MC series chamber. The concrete collar, concrete slab, nyloplast inspection port, SDR 35 pipe, Inserta Tee and minimum width requirements. A note suggests inspection ports may be connected through any chamber corrugation valley.
